Open House
Hosted in the POA Courtroom at Town Hall on Thursday, May 14 from 4-6 p.m.
Project Background
The Robinson Street infrastructure (water and sewer) was constructed in the 1950’s and has long outlived its service life. The street was identified for total reconstruction in 2026 within the Town’s Asset Management Plan.
The Robinson Street Reconstruction Project will begin on Tuesday, May 19, 2026 and is anticipated to be completed by the end of July 2026.
Updates will be provided by hand-delivered notices to residents on Robinson Street, regular updates via Block Captains, and on this page. Click the "follow" button to stay up-to-date on the project.
Notices
FAQs
FAQs
This project was already tendered and awarded for construction in the summer of 2026. Construction work will typically take around 14-16 weeks from beginning to end. Key dates can be found in the Project Timeline located on this page. You can also click the "Follow" button to be notified about updates to the project.

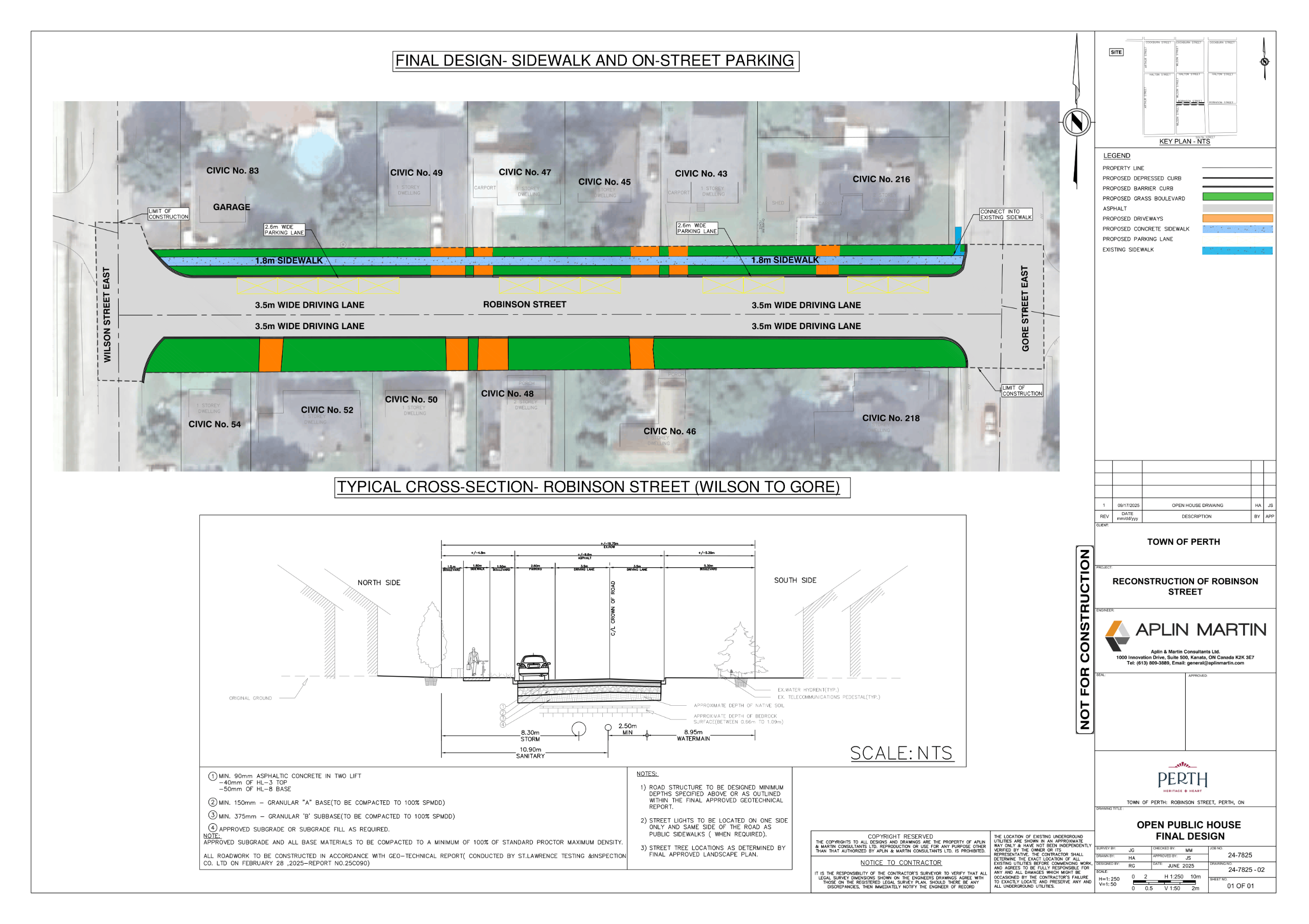

Robinson Street will be constructed to a uniform curb-to-curb width of 9.5m including a 2.6m wide parking lane that will be constructed along the westbound lane. This road is designed to meet the minimum operating width for a local residential road. This width allows two for lanes of travel with a designated parking lane and new curb and gutter along both sides of the road. The existing road will be adjusted accordingly, resulting in a straightened road with a uniform width. The existing concrete sidewalk along the westbound lane will be replaced with a new concrete sidewalk with a uniform width of 1.8m.
Individual homes will be provided with temporary overland water services while watermain construction is carried out. Please use care around temporary water lines to protect them from damage.
Service will likely be disrupted for a short period of time when this system is first hooked up and when it is ultimately disconnected. The temporary water service is installed and maintained by Town of Perth staff. Any calls regarding this service should be directed to 613-267-1072 both during regular hours and after hours.
Water meters will be shut off during this period and all landowners will be charged a minimum flat rate for water consumption. Individual notifications will be sent out with temporary servicing details several weeks in advance of construction.
Water and sewer services will be completely replaced up to the property line for each property taking service from Robinson Street. All water and sewer services within each private lot remain the responsibility of the homeowner.
Records remain vague regarding the exact date and age of the infrastructure in Robinson Street. Based on material type alone, the water and sewer mains on this block are certain to be over 50 years old. Based on our condition assessments, this infrastructure has long outlasted its service life. Knowing the mains are due for replacement, the probability remains high that private sewer and water lines are also in need of replacement.
The Town of Perth will be assessing the condition of services during construction and will try to provide recommendations to homeowners where possible based on what is encountered "in the trench". Owners should keep in mind that planned plumbing work is always less costly than emergency repairs.
New storm sewer services will be installed up to the property line for each property. It is the responsibility of the homeowner to cover the cost of installing the storm service from the property line to the home. New storm sewers allow homeowners to disconnect sump pumps from the sanitary system and direct stormwater into the new storm sewer or onto the lawn of their property.
Regulations within the Sewer Discharges By-law #1969-2066 prohibit property owners from discharging foundation drains or roof drains into sanitary sewer services. If owners are presently in violation of this by-law, they should make plans to have these systems separated. Roof drains should be directed to the ground surface on each property away from the foundation of the home.
On-street parking will be prohibited within the construction area for the full duration of the contract. Due to the nature of the work being performed, on-street parking cannot be accommodated while excavation work is carried out. Traffic within the block will be restricted to local traffic during the construction of piped services and will be open to one-way traffic after buried services are complete. Residents will continue to have access to and from their properties, however, there may be short periods when individual access points are taken out of service.
Pedestrian corridors will be maintained during construction but may be restricted to one side or another.
Suppose the work on the street by the Contractor (Ingimundson Construction Ltd.) impedes the Town's waste collection contractor from picking up garbage, recycling, and green bins on their regular route. In that case, the Contractor will work with the waste collector to arrange a designated area for bins to be set out, with bins returned to the correct property following collection. It's strongly recommended that residents write their name and address on their bins to ensure they return to the right place.
Residents who have flowers, shrubs, or irrigation works within the public boulevard should arrange to have these features removed prior to construction. All efforts will be made by the Town of protect existing trees within the work area, however some removals are anticipated. The Town of Perth will be contacting specific residents where tree removals are considered unavoidable.
There are no blasting activities planned for this project.
